road fall trees and greenery

West Roosevelt Sewer Improvement Project

Project Update

The project is currently in the Stage 2 Traffic Pattern with traffic returned to normal flow east and west, with only one lane in each direction is open. Construction will continue along the median on both sides. Beginning the week of 7/21, westbound traffic on Roosevelt between 44th and 46th will shift to the eastbound lanes. Westbound traffic between Sherman and Medford Ave is also currently shifted to the eastbound lanes.

Residents can expect the intersection 58th Street at Roosevelt Drive to be closed the week of 8/11 for approximately 1 week as the contractor completes removals on an existing structure. Traffic on Roosevelt will not be impacted but there will be no through traffic on 58th during this time.

Work completed to date includes:

  • Construction of 6 shafts with the deepest at 89 feet; and the shallowest at 21 feet, used to lower the machines and workers down to the work zone.
  • Construction of 5 manholes for maintenance of the new sewer.
  • Laying 3160 linear feet of new 48” pipe.
  • 6 different City of Milwaukee sewer connections to the new 48” pipe

Current work:

  • Backfilling all excavations
  • Street/sidewalk restoration
  • Abandoning old 42” sewer and manholes

The project is expected to be completed this fall. Pending any delays or issues the 51st street corner should be open to pedestrians by the start of the school year.

We want to thank the residents for their support and patience during the construction of this important project.

Project Overview

In 2020 the Milwaukee Metropolitan Sewerage District (MMSD) completed a planning study to develop system improvements that would reduce wastewater levels in MMSD sewers on West Roosevelt Drive and eliminate a sanitary sewer overflow connection to an existing City of Milwaukee storm sewer.

The West Roosevelt Sewer Improvement Project resolves to achieve both these goals. First, the construction of new MMSD and City of Milwaukee sewers and manholes will reroute high wastewater flows to areas of the MMSD sewer system that have a greater capacity to handle excess wastewater during wet weather events. Second, the removal of a sanitary sewer overflow pump station at North 35th Street and West Roosevelt Drive will allow the construction of the MMSD’s West Basin Stormwater Management Project, which is the third and final component of an integrated system to address recurrent flooding in the 30th Street Corridor.

Project Map

Project Goals

Timeline

  • Design and Pre-construction: Spring 2021 - Spring 2023
  • Construction: Fall 2023 - Winter 2025
  • Post Construction: Winter 2025 - Spring 2025
  • slide

    Delivery of 48-inch pipe for the new sewer.

  • slide

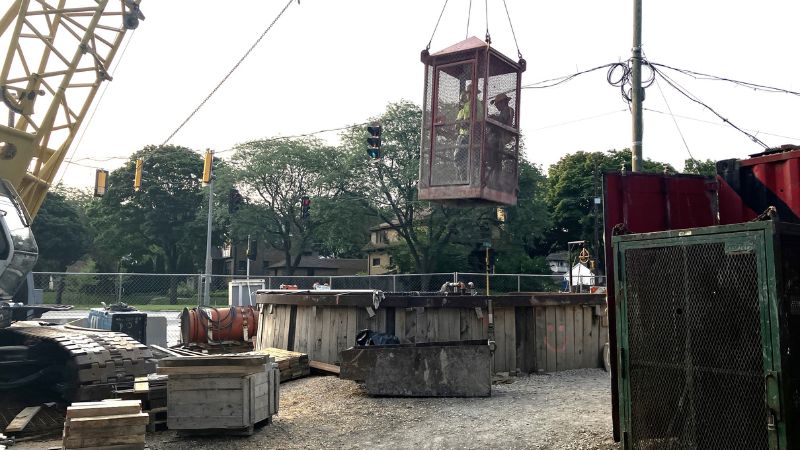

    Work crew lowered into the shaft at 51st St.

  • slide

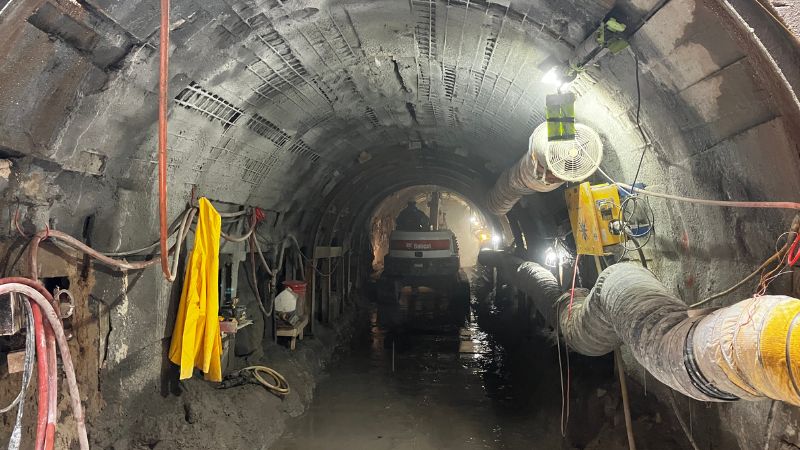

    A view of the crew at work in the tunnel at 51st St.

  • slide

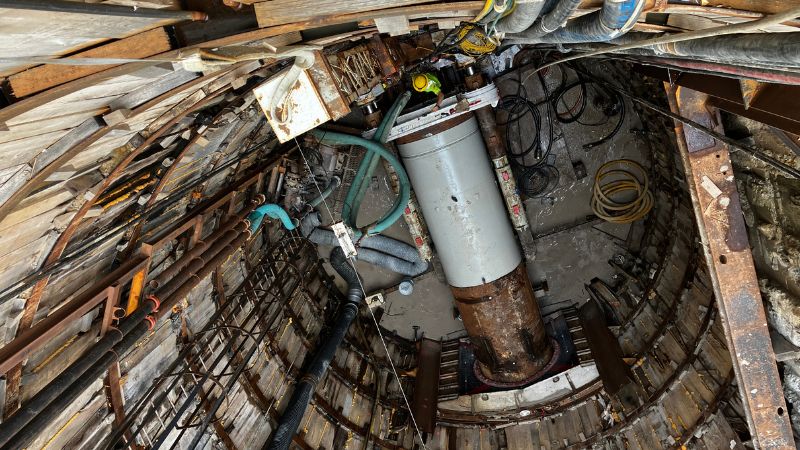

    New pipe being pushed into place in the tunnel at Scranton Pl.

Partners

Get Involved/Stay Informed

  • Sign up to receive West Roosevelt Drive Project updates in your inbox below.
  • Follow MMSD on social media (Instagram, Facebook, X) for updates on MMSD projects.

Project Resources

August 10, 2023 -- Open House posters of new traffic patterns during construction

Contact Us

*
*
*
